Tracking equipment hours: the meter, the code and the idle hours, every day

By Review.LivePublished 3 min readHow we write

The weekly equipment sheet lists one total for the excavators and loader. The loader has scarcely moved, while one excavator has spent most of the week on culverts. The superintendent cannot explain either machine's activity costs from that combined number.

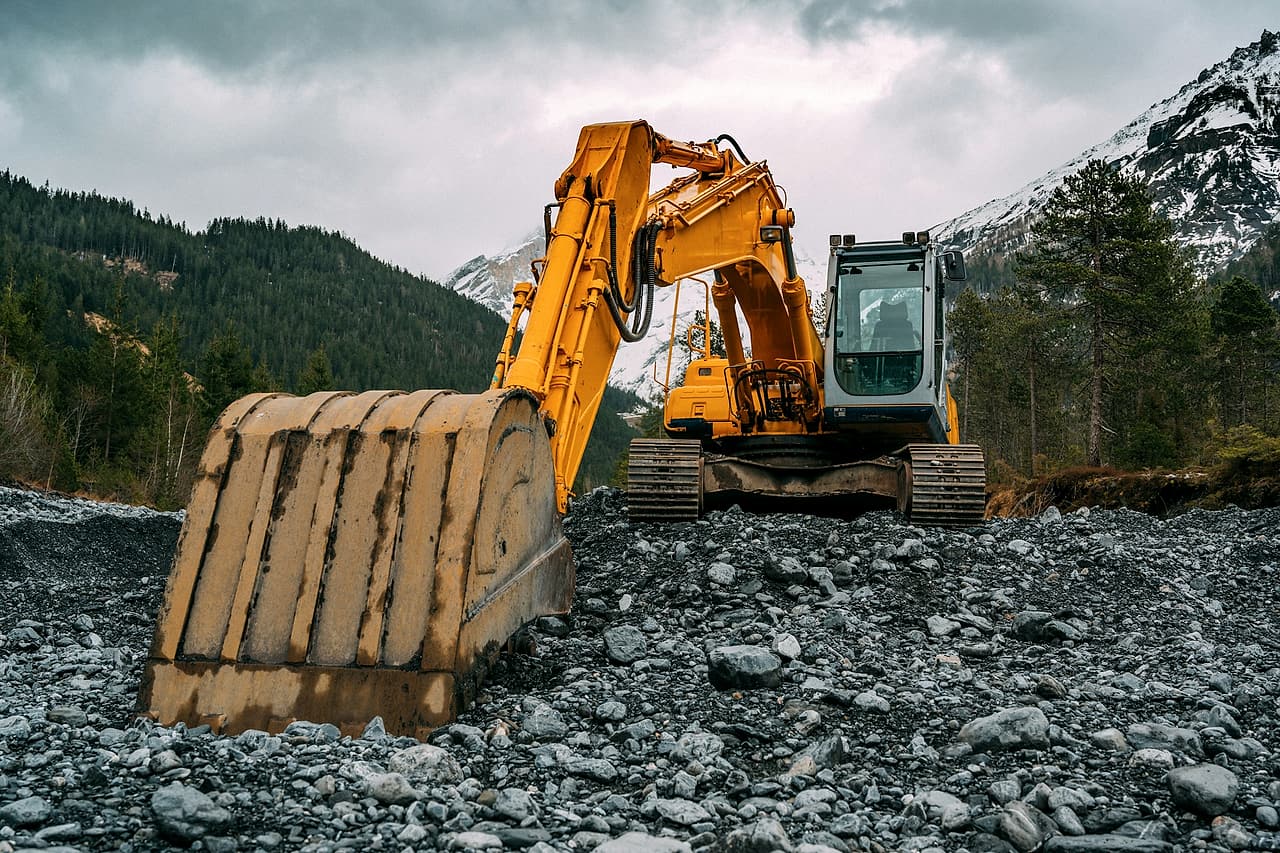

A yellow excavator sits idle on a gravel bed with its bucket lowered and the cab empty, forest and snowy mountains behind.
Photo: Gerold Hinzen on Unsplash

Keep a daily record for each machine, with its meter readings, the activities it served and idle periods recorded on a clearly stated basis. Confirm what that machine's meter measures; meter movement, productive time, attendance and billed rental time may differ. Use the log to allocate activity usage and investigate gaps. Calling off a rental belongs to the rental decision, while this lesson makes the underlying daily record usable.

Separate the readings from the activity record

  1. Identify the machine and method. Record a stable equipment ID, meter type and who supplies the reading. Use the approved operator or fleet reporting process; do not ask someone to access operating equipment merely to collect a number.
  2. Capture start and end readings. Note the date and units alongside the figures. Flag a changed, failed or reset meter immediately. Keep the original reading visible if a correction is made rather than filling a gap with a plausible guess.
  3. Record the work allocations. List activity codes, locations and the time basis used for each split. If the machine changes tasks, capture that move during the day. Keep unallocated time visible until its use is clarified.
  4. Log idle periods separately. Record when the machine was unavailable or waiting and the observed reason. State whether the engine was running if relevant to the reporting method. Do not assume every clock-hour of waiting appears on the meter.
  5. Reconcile the weekly totals. Compare activity allocations with the daily record and investigate differences. Post the agreed equipment cost or hours to the codes, retaining the method so the budget comparison uses compatible units.
  6. Compare usage with the charge. Read the actual rental agreement's period, included hours and other charges. Show productive use beside that charging basis. Refer uncertain standby recovery or rental decisions to the responsible project manager instead of treating a low meter total as a billing error.

Common mistakes

  • Combining similar machines before their individual allocations are checked.
  • Subtracting productive hours from meter hours and calling every difference standby.
  • Comparing a daily usage total with a weekly bill without reading its terms.

Checklist

Each machine's daily line

  • Equipment ID and meter units.
  • Readings with date and reporter.
  • Activities and allocation basis.
  • Idle period, observed reason and clock-time basis.
  • Unexplained gap flagged for review.
  • Rental charge basis identified separately.

Check your understanding

The engine was off during a waiting period. Should you add those clock-hours to the meter difference?

Show the answer
Record the waiting period separately under the agreed method and preserve the actual meter readings. Mixing clock time with a meter total obscures what each figure means. The rental and cost-allocation rules must be checked on their own basis.
