QA/QC inspections
Construction QA/QC inspections, with the failures followed through
An inspection starts from a template — six come built in, and a company adds its own — and walks the inspector through each item: Pass, Fail or N/A, a note, a photo. A failed item raises a corrective action with an owner and a due date. The inspector signs on the device, the record is frozen, and the PDF shows exactly what was signed.

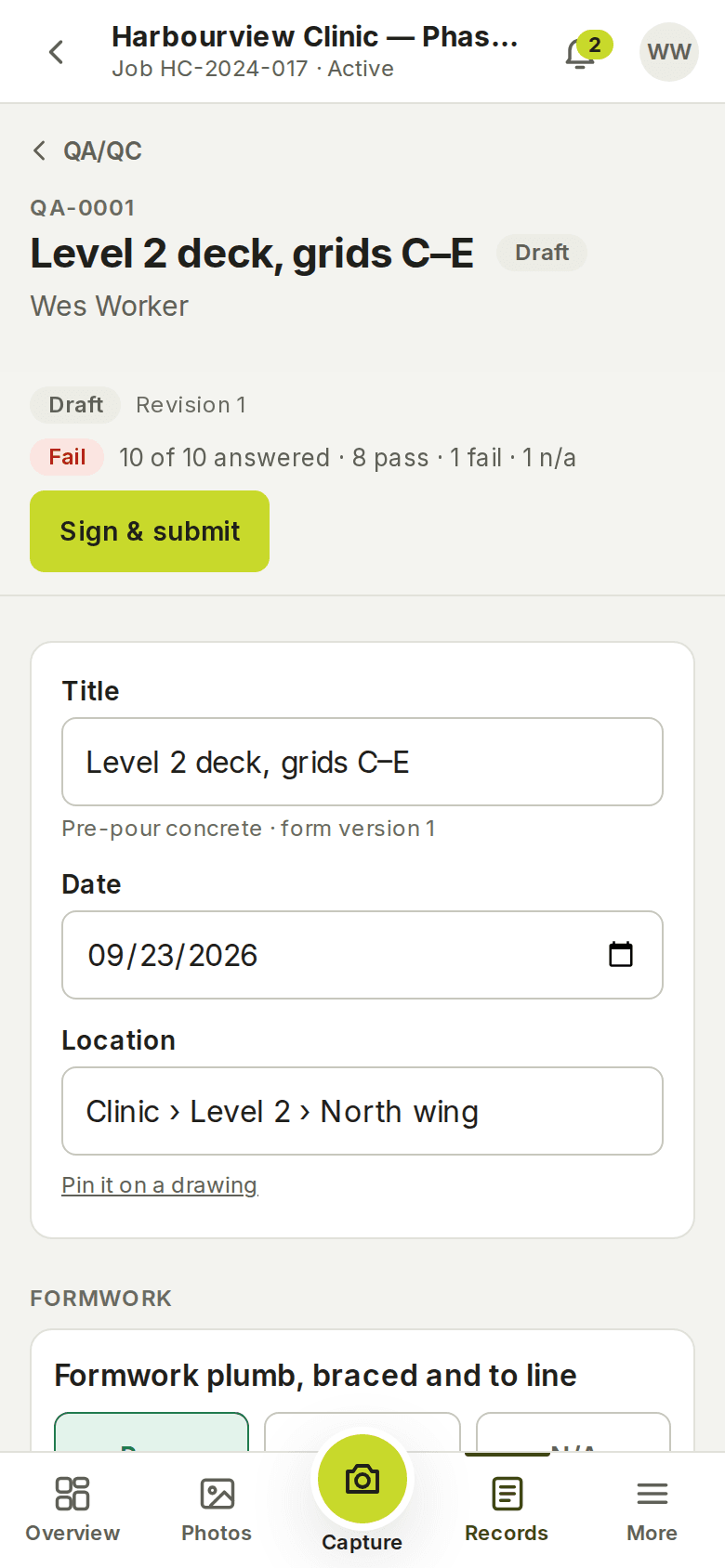

In the field / 01
Templates the whole company shares, versioned
Built in: a general inspection, pre-pour concrete, waterproofing membrane, MEP rough-in, a safety walk and a deficiency review. A company’s admins add their own checklists in company settings and hide the built-in ones they never use. Every inspection keeps a reference to the exact template version it was made from, so a checklist edited next year does not change what was inspected this year.
Check the work
Clear results, evidence and follow-up
Fixings checked
Connection details match the drawing.
PassRecord the evidence
Add a photo and notes to the checklist item.
Make the checklist fit
Add, remove or reorder items while drafting.
In the field / 02
Pass, Fail, N/A — and what happens next
Each item takes a result, a note and a photo. A required item must be answered before the inspection can be submitted. From a failed item the inspector raises a corrective action — a description, who owns it, when it is due — and the action moves through open, in progress, resolved and verified, with each step recorded. Actions are numbered per project and never renumbered.
Check the work
Clear results, evidence and follow-up
Fixings checked
Connection details match the drawing.
PassRecord the evidence
Add a photo and notes to the checklist item.
Make the checklist fit
Add, remove or reorder items while drafting.
In the field / 03
Signed on the device, frozen as a revision
The inspector signs on the phone’s screen — the drawn signature, the typed name and company, the acknowledgement text they agreed to, the server’s time — and the signature is bound to the revision and its checksum. Submitting freezes the revision; a manager reviews, approves or asks for a revision, and a correction is a new revision with the earlier one kept.
The PDF renders the frozen revision with the results, notes, photos, actions and the signature. Inspections can be pinned to a plan sheet like any other record, so a reviewer sees where on the drawing it was.
Choose your form
Daily reports, inspections and T&M
Daily report
Record the day's work.
QA/QC inspection
Complete a checklist that fits the job.
T&M ticket
Record extra work and collect signatures.
Included in the record
- Per-project number (QA-0001…), title, work date, location, status and revision
- The template and the exact template version used
- For every item: section, label, guidance, required or not, the result, a note and photos
- Corrective actions: number, description, the failed item, owner, due date, status history
- The inspector's signature: image, typed name and company, acknowledgement text version, server time, verification method
- The frozen snapshot of each revision with its checksum
- Plan sheet, revision and point; comments; the PDF
Good to know
Templates are lists of items, not branching forms: there are no conditional questions, numeric tolerances or calculated fields. Signatures are drawn or typed acknowledgements recorded with the server’s time and the signer’s session — not a certificate-based digital signature. Inspections are the company’s own; the product does not send them to an authority. For extra work found during an inspection, see T&M records.
